Quality Control & Trial Assembly for Custom Retail Displays
Check Production Details Before They Become On-Site Problems.
A display can look perfect in a rendering but still have problems during production or local installation. Colors may not match. Coatings may fail. Parts may not fit together. Samtop checks key details before, during and after production -- and arranges trial assembly for complex structures.
Quality Checks Before, During and After Production
Quality control works best when problems are found early, not after the full order is finished.
Agree on What the Finished Display Should Look Like
We use approved drawings, physical samples, material specifications and finish references to set the quality requirements. For displays made from different materials, we pay special attention to color, gloss, surface texture and important connection dimensions. These approved references help the production team understand what needs to match.
Approved samples · Drawings · Finish references · Material specs
Find Differences Before They Affect More Parts
We check important details during manufacturing, especially before parts move to the next process. If painted panels show a color difference or surface problem, we can review the affected parts before the same issue continues through production. For repeat orders, we also pay attention to visible differences between units.
Color checks · Surface inspection · In-process review
Check the Complete Order, Not Just Individual Parts
Final checks cover the finished appearance, required components, quantities, functions and accessories. For complex structures, trial assembly helps check how parts fit together. Inspection photos, assembly records or other agreed information can be prepared for customer review before shipment.
Final inspection · Trial assembly · Shipment confirmation
What We Check on Custom Retail Displays
Different retail displays have different risks. We focus on the details that can affect the finished appearance, product use and local setup.
Color & Surface Finish
We compare production parts with approved samples and check visible defects such as scratches, uneven paint, marks, bubbles and surface texture differences. A small color or gloss difference can become obvious when several parts are placed together.
Dimensions & Critical Fit
A small error in a fixing hole can stop a large display from being assembled. We check key dimensions, hole positions, edges and connection points against approved drawings.
Graphics & Logos
We check artwork placement, size, alignment, printing quality and visible consistency between repeated parts. An incorrect logo position or printed color can affect the whole presentation.
Product Fit & Presentation
Where suitable product dimensions or physical references are available, we check the fit and presentation of the displayed products. A perfume bottle or watch pillow that does not fit correctly can make a display difficult to use.
Hardware & Connections
Missing screws or incorrect brackets can delay installation. We check required hardware, connection points and component matching. For complex projects, these details can also be reviewed during trial assembly.
Function & Moving Parts
Drawers, removable trays and other moving parts need to work after the display is assembled. We check relevant movement, clearance, fit and operation.
Lighting & Electrical Components
For illuminated displays, we check relevant lighting functions, connectors, wiring positions and visible lighting results. Lighting problems may not appear until the components are connected.
Final Appearance & Packing Details
Parts may look correct separately but show gaps or alignment differences when assembled. We check the relevant finished appearance, required accessories, component identification and packing details before shipment.
Performance Testing for Retail Display Materials & Finishes
Some quality risks cannot be found through visual inspection alone. Samtop can coordinate project-specific testing through manufacturing partners or third-party laboratories.
Cross-Hatch Adhesion Test
Paint and coating adhesion
Checks how well a paint or coating stays attached to its base material. This may be required for painted metal, MDF panels and other coated display components.
Salt Spray Test
Corrosion resistance
Evaluates how metal finishes and protective coatings perform under specified salt spray conditions. This may be important for metal fixtures and premium watch displays.
UV Exposure Test
Color and finish durability
Helps assess fading, yellowing or other changes after UV exposure. It may be useful for window props, printed graphics and decorative finishes.
Perfume & Alcohol Resistance Test
Protection against fragrance contact
Checks how selected materials and finishes react to perfume or alcohol. This is especially relevant for perfume testers, acrylic holders and painted surfaces near fragrance products.
Abrasion & Scratch Resistance Test
Surface wear
Helps assess how finishes perform when exposed to rubbing, handling or surface contact. This may be useful for display trays, counters and frequently touched components.
Load & Stability Checks
Structural performance
Checks relevant load or stability requirements for shelves, supports and freestanding displays. The method depends on the display structure and intended use.
For certain luxury watch display projects, cross-hatch adhesion, salt spray, UV exposure and perfume resistance testing can be arranged through one manufacturing partner.
Testing is based on project needs. Methods, test duration, acceptance criteria and testing arrangements are confirmed according to the materials and customer requirements. Not every display requires every test.
Individual Parts Can Pass QC and Still Fail at Assembly
A metal frame can meet its dimensions. An acrylic holder can have a good finish. An MDF panel can match the approved color. The hardware may also pass inspection. But the complete display can still have problems when these parts come together.
A hole may not line up. A panel may not fit. A connection may be difficult to reach. The assembly order may create problems for the installation team.
Individual component inspection does not always show how the complete display will work.
For complex projects, we can assemble the complete display or its key sections to check important connections and assembly details. This helps find problems before the parts are packed and shipped.
Individual Component Checks
Final Assembly
Trial Assembly Before Shipment
Trial Assembly
in Practice

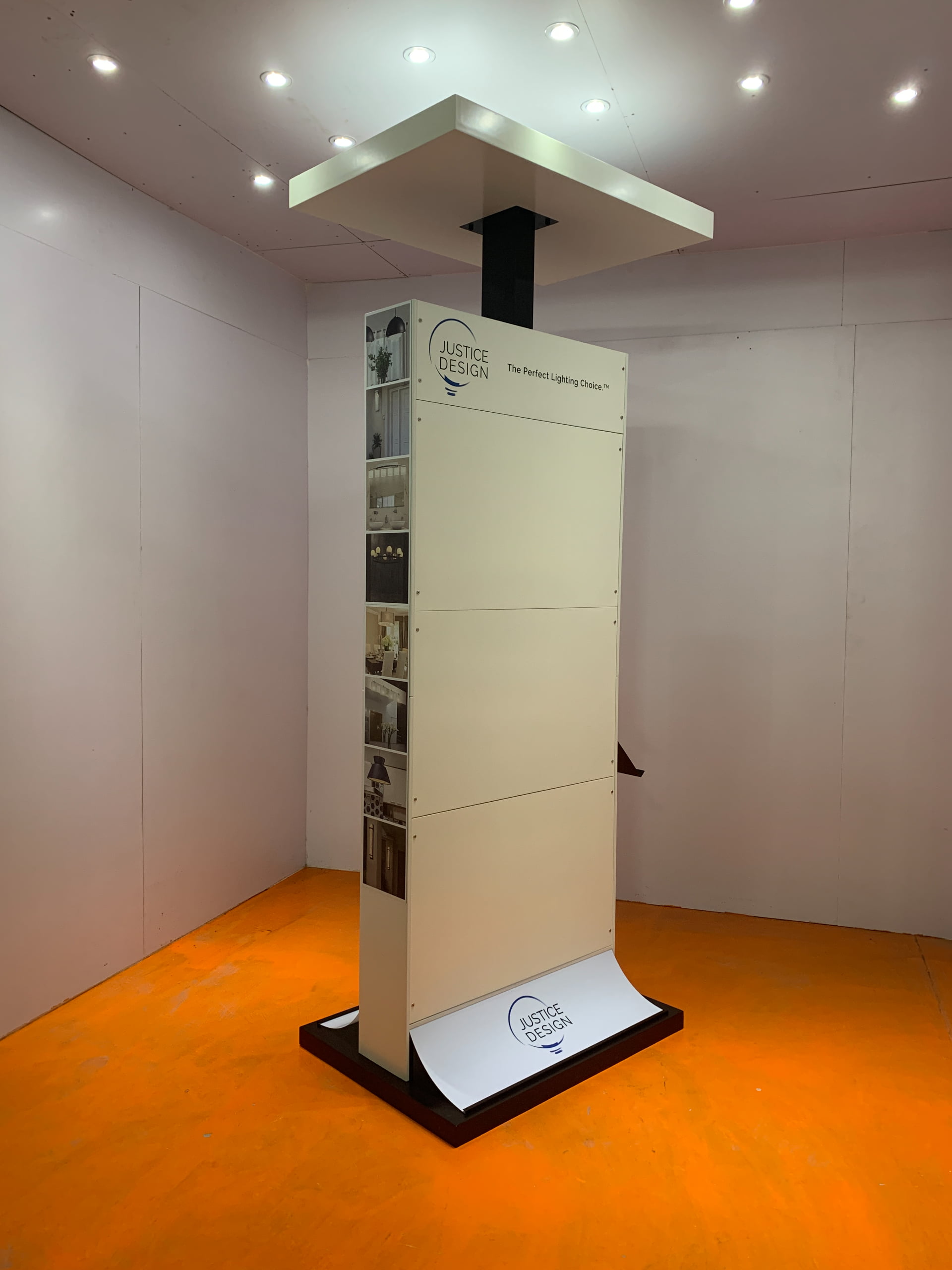

Checking the fit before the display reaches the installation site -- freestanding lighting display.

This freestanding lighting display includes a metal support structure, large panels, a raised canopy, graphics and several connection points. The display was assembled in the workshop before shipment to check how the main components came together.

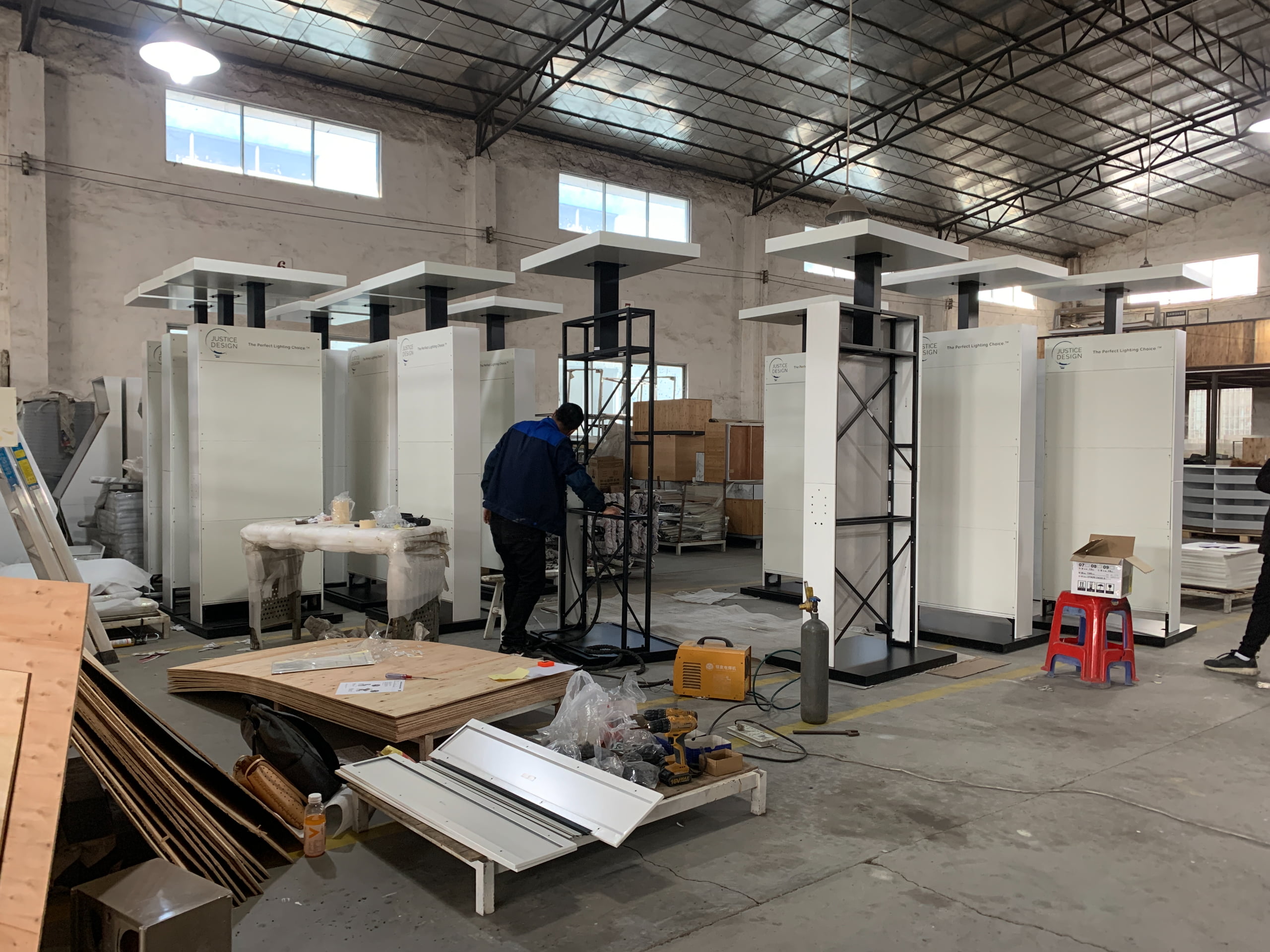

The panels were fitted to the support structure using the required hardware. This helped check connection positions, panel fit and access for fastening.
Panel & Hardware Fit

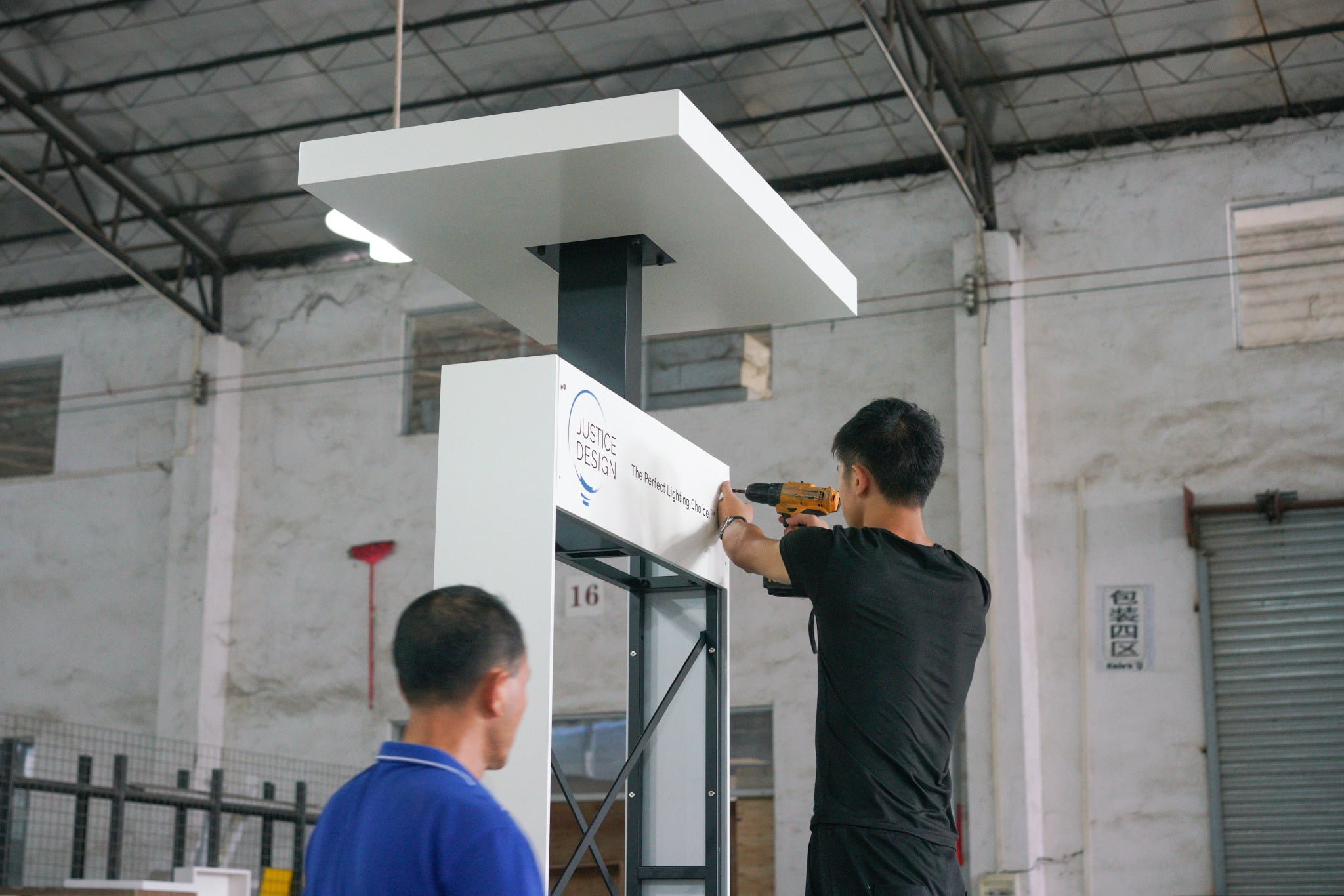

The base, upright support and top canopy were brought together during assembly. This allowed the team to review how the main structural components fit as one display.
Main Structure & Canopy

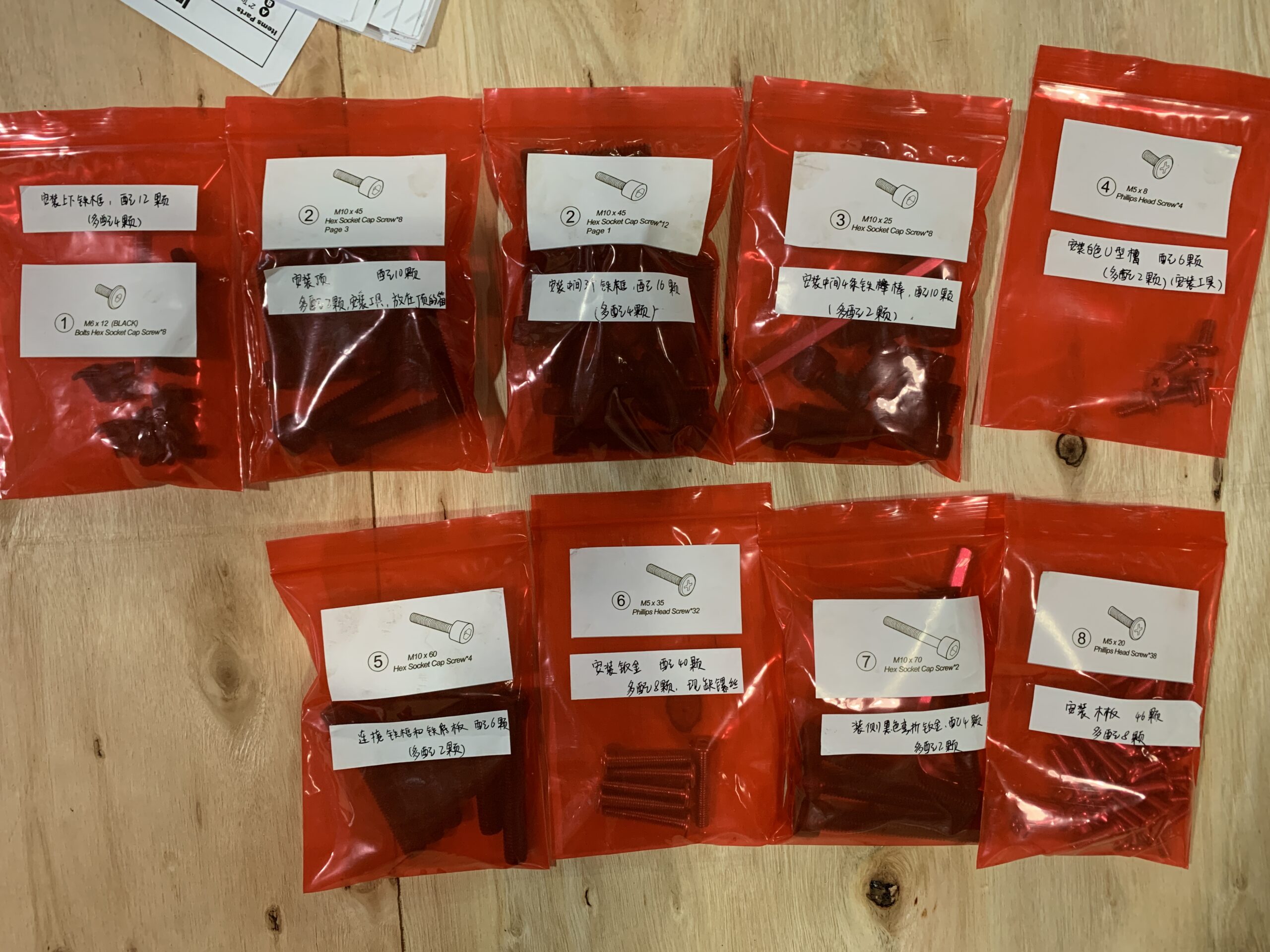

Screws and other hardware were sorted into labeled packs. Together with assembly references, these details help the receiving team identify the parts needed for setup.
Hardware Identification
Trial assembly helped the team understand the installation order and identify details that could make local setup more difficult.

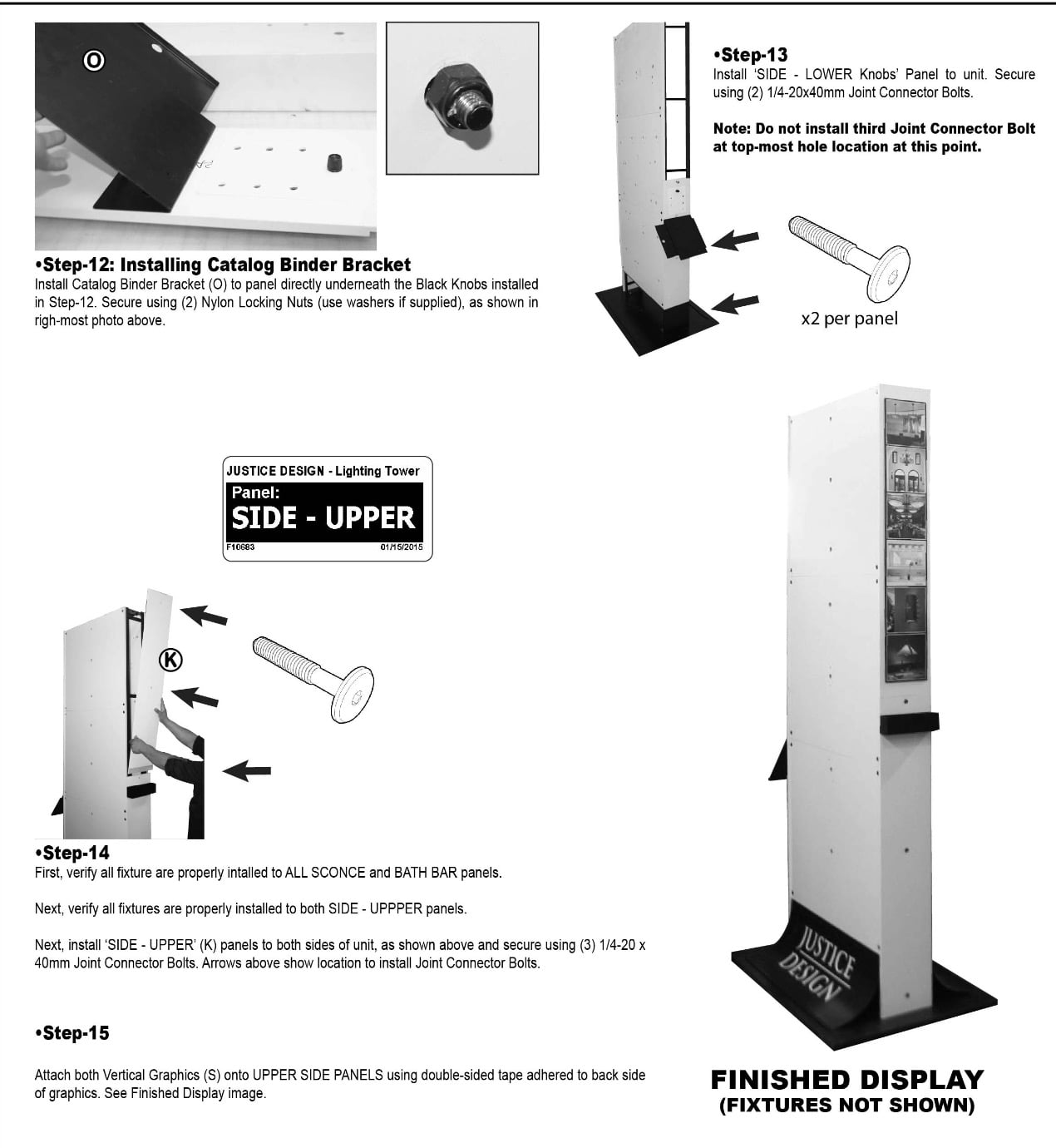

Assembly Sequence
Trial assembly is not only about seeing the display standing in the factory. It is about checking the connections and installation details before the display reaches the site.
What Happens When a Quality Issue Is Found?
Finding a problem is only useful when the next steps are clear.
Identify
Find the affected part, finish, dimension or assembly detail.
Compare
Check the issue against the approved sample, drawing or agreed requirement.
Correct
Work with the relevant production team to arrange the necessary correction. If the solution changes an approved detail, we discuss it with the customer first.
Recheck
Check the corrected details again before the next production stage or shipment. This helps reduce the risk of the same issue moving into later production steps.
Quality Control & Trial Assembly FAQs
Practical answers for overseas clients on inspection, shipment confirmation and local installation.
Can our team or a third-party inspector check the goods before shipment?
Yes. We can help coordinate a customer-appointed inspection at the relevant production site, subject to scheduling and site access. Please share your inspection checklist and required standards in advance so the production team can prepare the agreed items for review.
What if we find a problem in the inspection photos before shipment?
Send us the photos or details showing what does not match the approved requirements. We will review the issue with the production team, confirm the required correction and arrange follow-up checks. Any changes to approved details will be discussed with you first.
Can you check the critical parts without fully assembling a large display?
Yes. For some large or complex displays, assembling key sections may be more practical than building the complete structure. We can discuss which connections and assembly details need to be checked based on the project.
What if our local installation team uses a different fixing method?
Please share the planned fixing method, site conditions and installation requirements before production. We can review the relevant display components and connection details. The local installer or qualified site engineer is responsible for confirming the final on-site fixing and safety requirements.
Can the display be taken apart after trial assembly and assembled again on site?
For displays designed for disassembly, trial assembly can help check the connections and assembly order. Afterward, components can be identified and packed with the required hardware and assembly references to support local setup.
What if our installer finds a missing or incorrect part after delivery?
Please send us the part number, photos and a description of the problem. We can compare the information with the approved drawings, parts list and available packing records, then review the next practical step with you. Any replacement or corrective arrangement depends on the findings and agreed project terms.
Reduce Production and Assembly Problems Before Shipment
If you already have a rendering, drawing or developed display concept, Samtop can help review the production requirements, plan relevant quality checks and arrange trial assembly where needed.
Share your drawings, dimensions, quantity, materials, finishes, delivery date and shipping destination. We will review the project and discuss the next steps with you.
